Anatomy of a Pothole Repair

dpw-opsFixing the pavement on an active San Francisco Street with two-way streetcar tracks takes a lot of folks from many backgrounds and disciplines. SFMTA & DPW work together with the rail division people to dig up the area around the tracks and determine the correct repair based on what they see under the asphalt. It is not rocket science but it is more challenging than one would expect.

First off, its dangerous. These people work in moving traffic. Motorists cut right through their job site. The equipment is super hazardous. So everyone wears bright colored green safety vests and every move is cautious. Half the crew has to be there just to watch the backs of their colleagues. That’s why they like to have 11 workers on scene, for the visual impact of all those green vests and orange cones. Safety has to come first.

d-sfmunirail-logoSecondly, it involves several departments and agencies of the City. SFMTA sends two groups into the field. The rail division people are responsible for the gauge area’s of the track (between the rails) and for two feet or so on each side of said track. Then the Sustainable Streets division take over for the rest of the pavement right up to the curb. But DPW has the large asphalt handling equipment. So everyone has to coordinate and show up at the right place ready to do their part. Choreography is the word. The actual repair job is like a musical act or a staged performance live in the streets.

17th Street has a bunch of pavement problems. Deformities, huge cracks, small cracks, chunks of pavement missing, dips and bumps, heavily degraded flange ways along the tracks, and several classic potholes. An argument could be made for repaving and resurfacing the entire street but the City has assigned a Pavement Condition Index score of 71 to our street and chose to patch certain spots.

One of the outcomes of the advocacy of neighbors on 17th street is that td-sfmta-logohe City has been notified that a hazardous condition exists on the roadway locally. The City really does have an obligation to fix this problem before more harm is done. On top of that our district Supervisor called a second meeting at City Hall to address the issue of bike safety along the 17th Street streetcar tracks early last month.

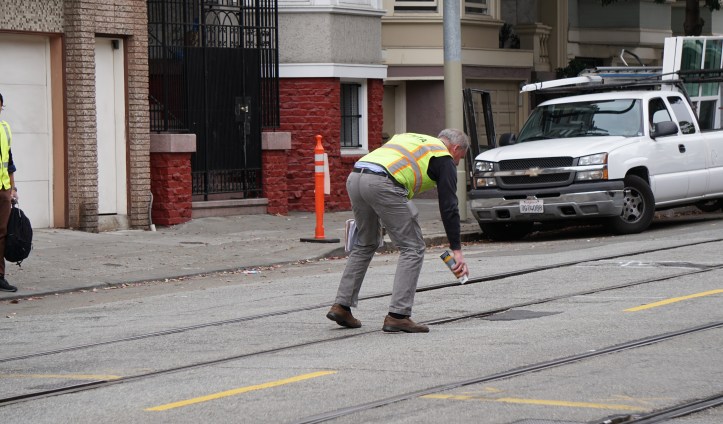

All of these pressures culminated September 29, 2016 causing Terry Fahey, the top guy at the rail division (overseeing several hundred employees) to visit to our little street, personally marking out the pavement deformities that needed immediate attention. Terry was met on site and walked 17th Street from Church to Noe with Oliver Gajda and Will Tabajonda, both from different parts of SFMTA.

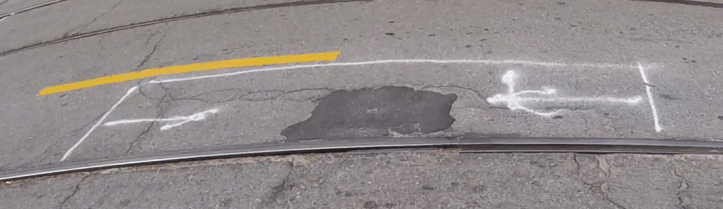

terryincaroliverterryandwillon17thstdsc00311terrymarkspotholeon17thst

Mr. Fahey and crew marked off seven different spots but we are going to focus on the two that actually were repaired and leave the five as yet not repaired pavement irregularities to another article. Here’s some pictures of two big problems on 17th Street near Church Street that did get properly fixed.

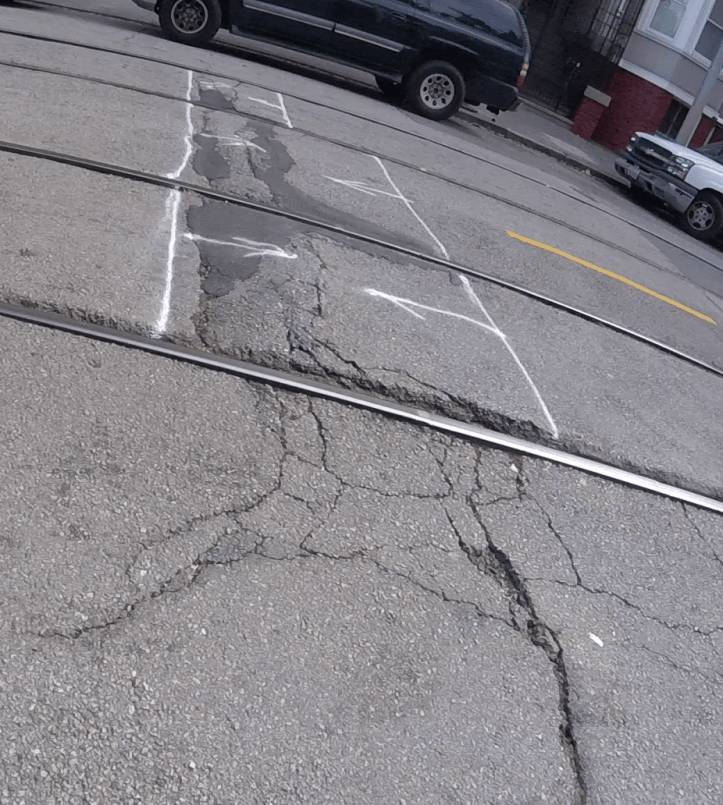

vlcsnap-2016-11-04-22h44m06s781vlcsnap-2016-11-04-22h44m40s373

vlcsnap-2016-11-04-22h44m51s331

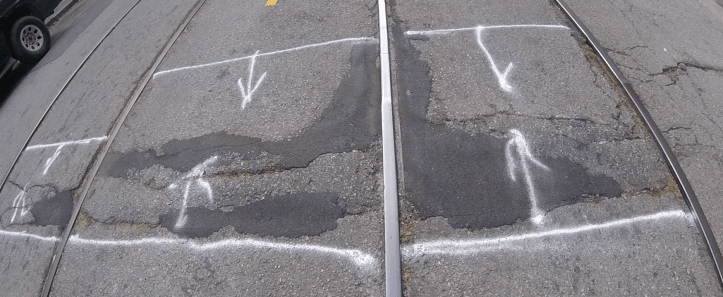

This was a buckle several inches high like a naturally occurring speed bump.

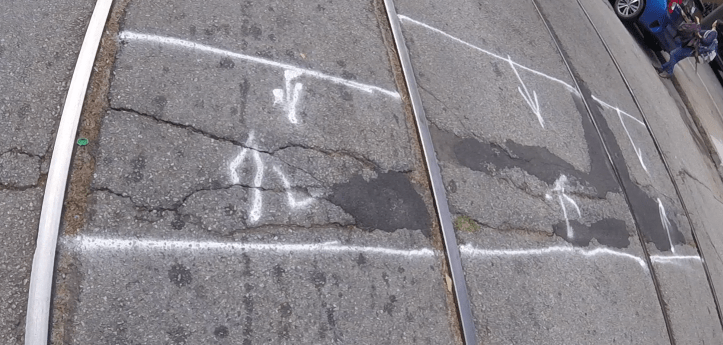

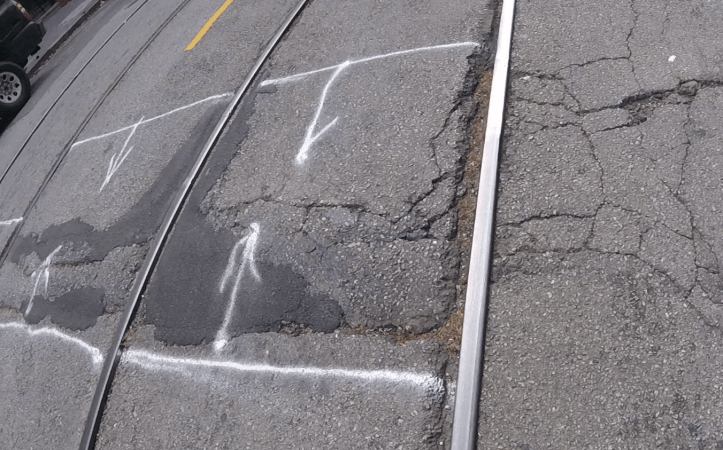

vlcsnap-2016-11-04-22h45m14s930vlcsnap-2016-11-04-22h45m56s421

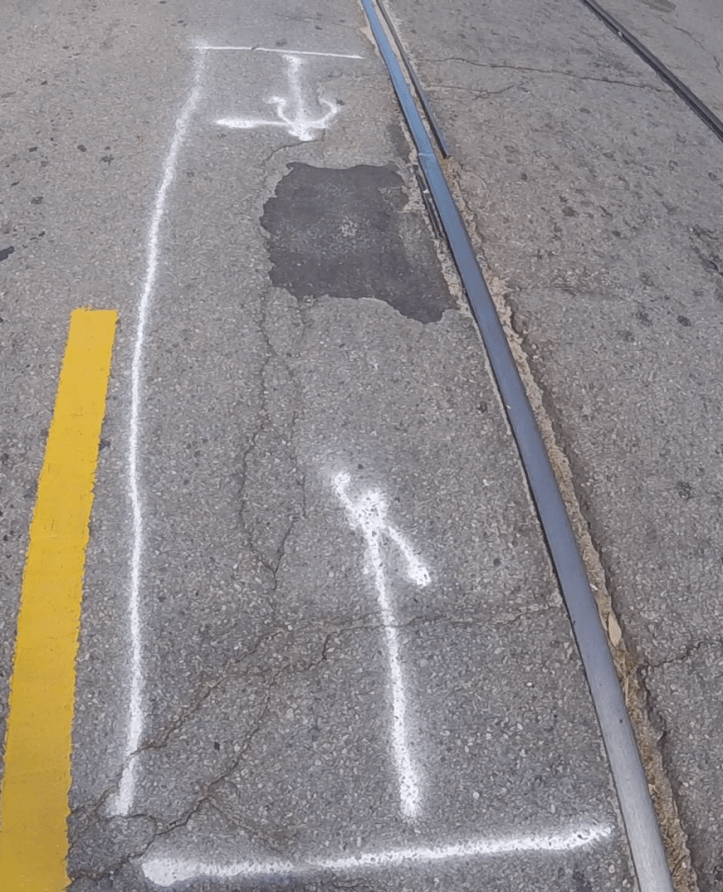

vlcsnap-2016-11-04-22h46m05s609

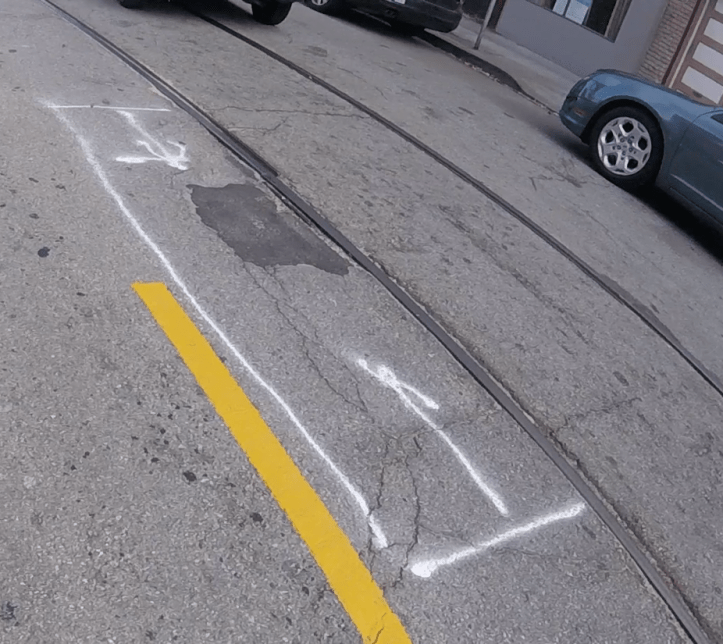

Here we see a previous patch that has failed.


Both of these areas are within twenty feet of each other so that makes it a bit nicer for the folks who come in next to do actual work. And that starts with the “No Parking” signs that have to be put up in advance.signspostedforpotholessignspostedmore

On the morning of October 6th (2016) the Calvary arrived. Okay, I’m exaggerating again but those big trucks, bright orange cones and day-glow green safety vests are impressive. The armada of heavy vehicles pulled through each carrying more people and equipment and before long the area was defined, new traffic lanes set up and the work commenced. The day isn’t over until the work is done. Once started, there are no breaks. That’s the way of the street.

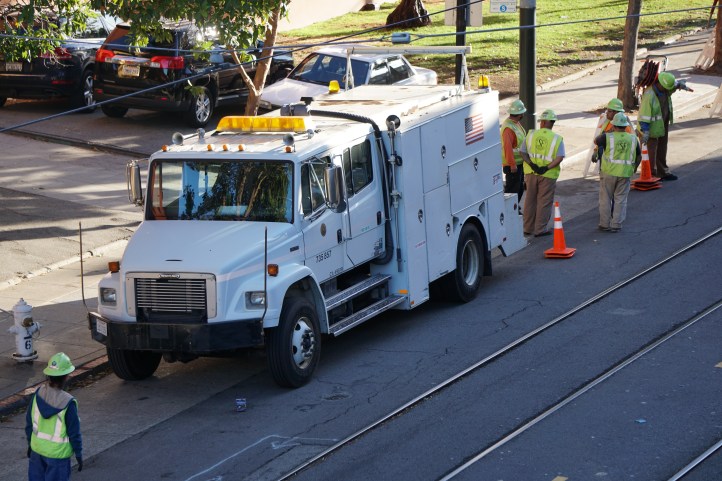

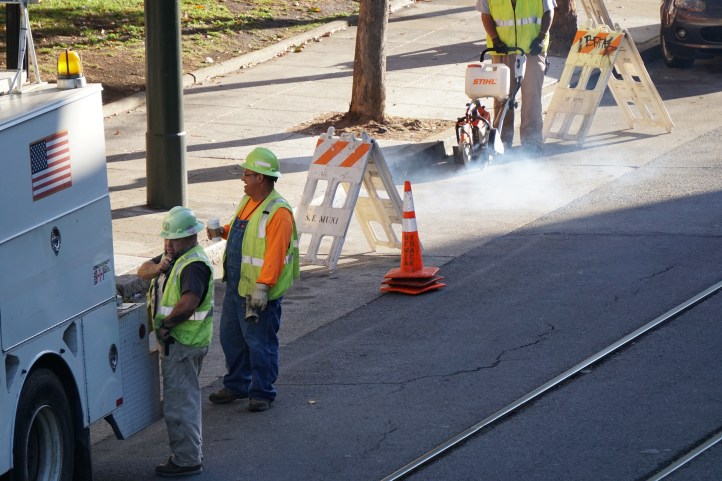

dsc01598

dsc01607
That is MUNI switch expert Dennis Callahan on the phone. He was there to supervise the rail related work.
dsc01622
The first workers arrive and establish their jobsite.

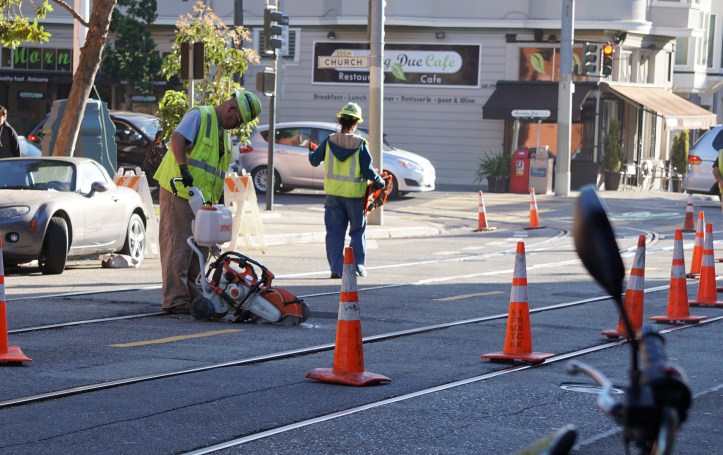

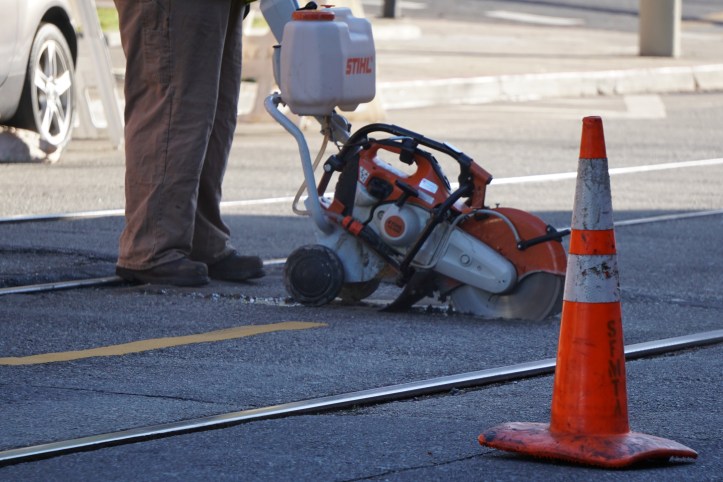

dsc01637

dsc01639

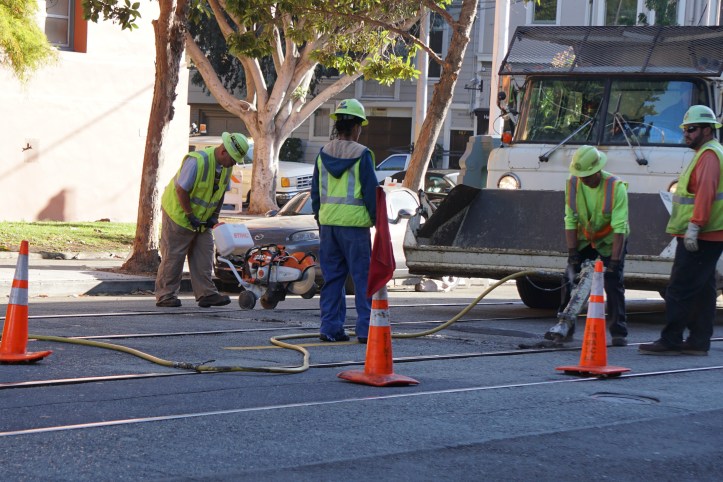

These saws just cut through the pavement like butter.
dsc01646

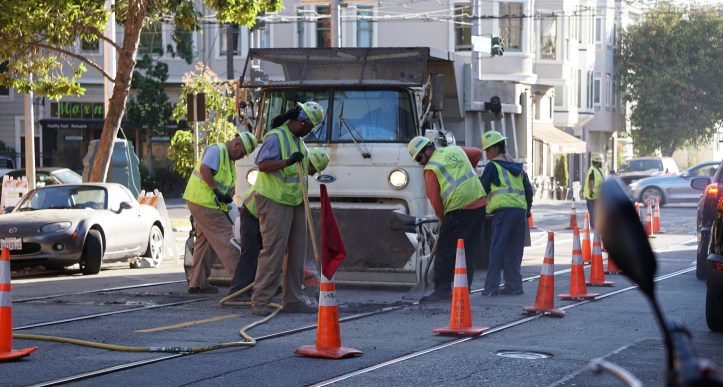

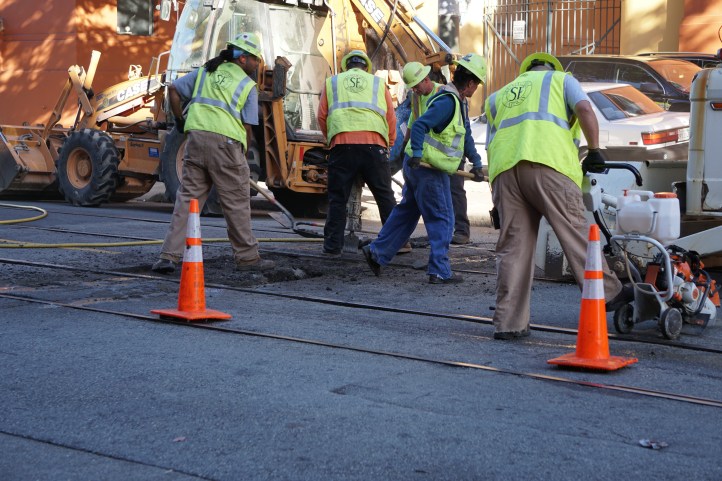

Enter the jackhammer.

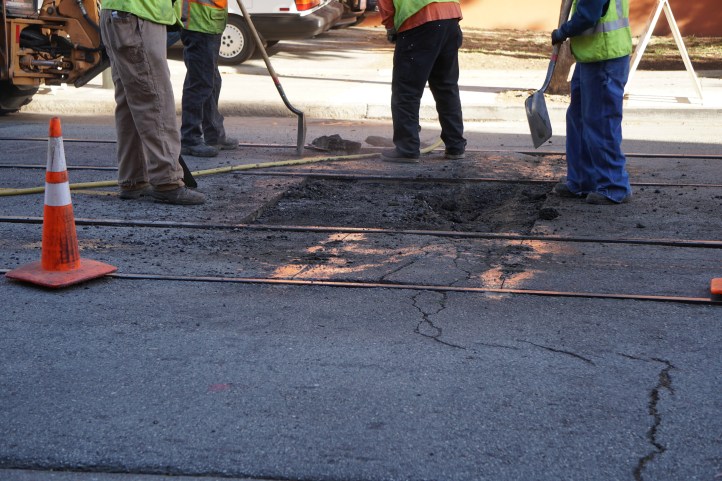

dsc01649dsc01651dsc01655dsc01677dsc01681

dsc01703

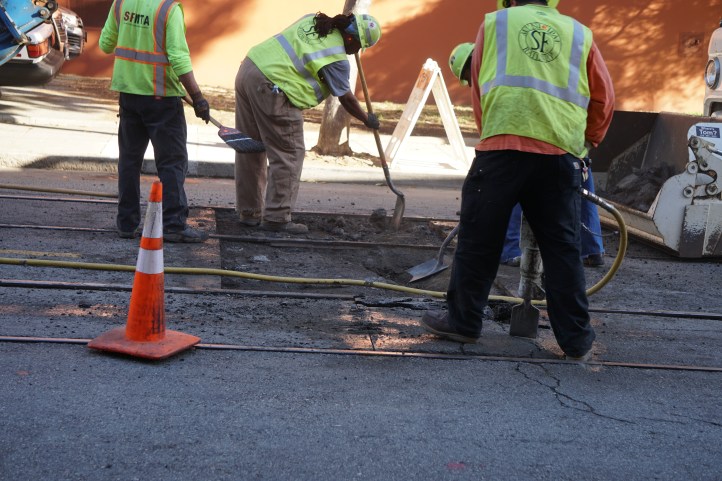

Very carefully, the surface disappears.

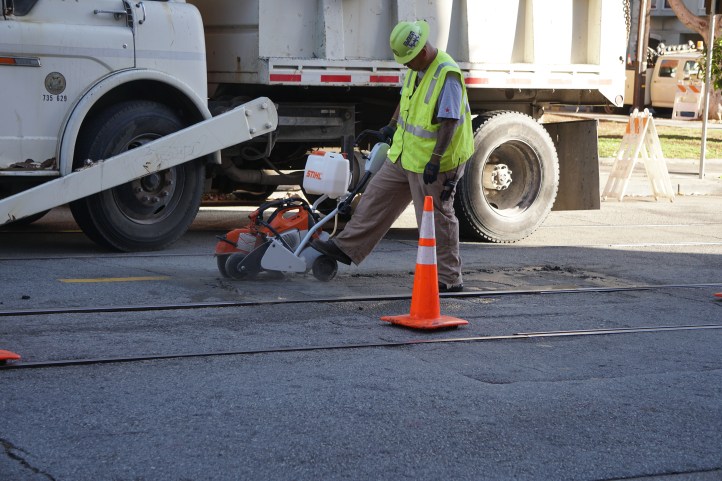

dsc01711
We start cutting the second area.
dsc01724

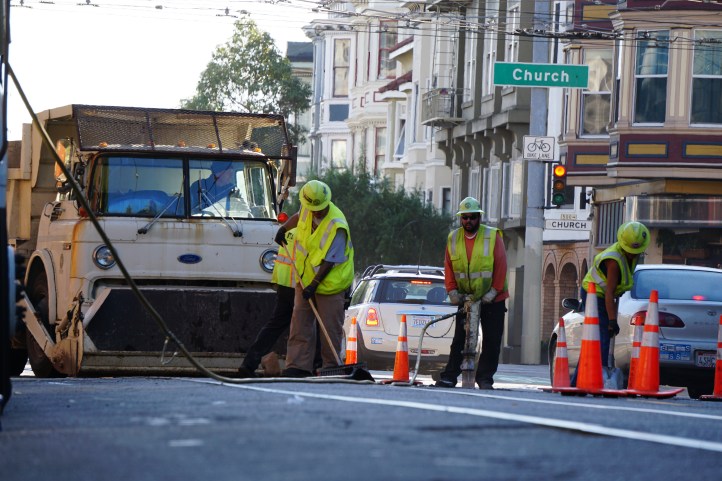

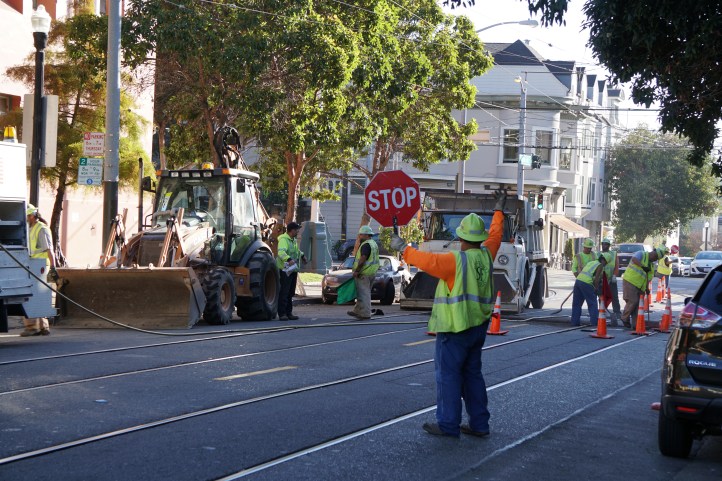

Pullback to see the folks conducting traffic throughout the day.

dsc01734

dsc01737
I don’t think they ever used the big shovel thing but it is nice to have just in case.
dsc01739

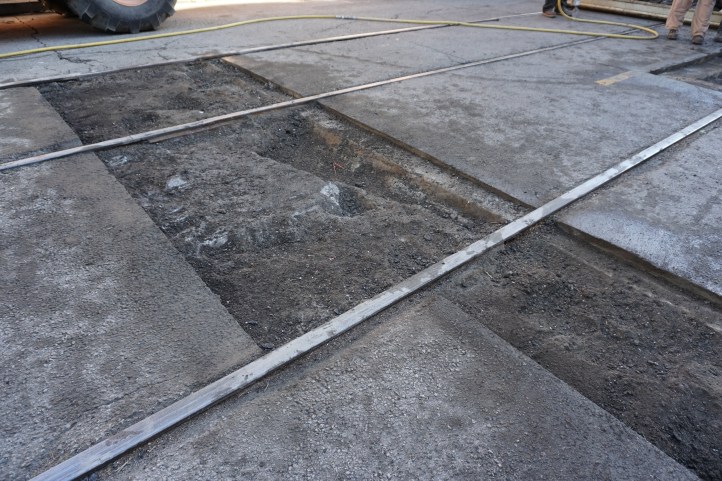

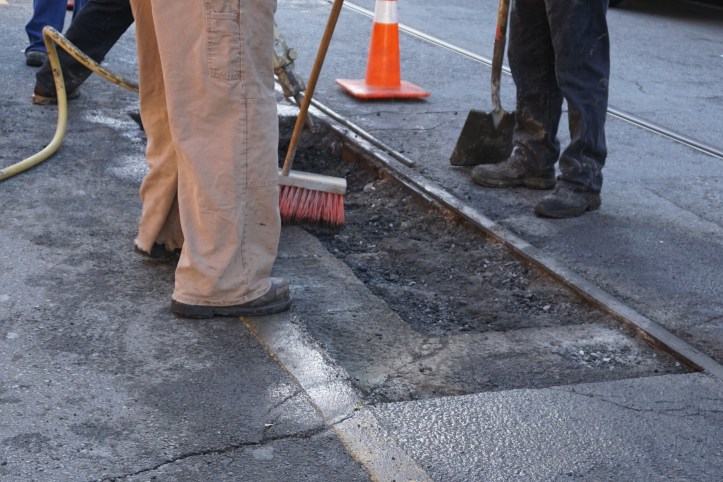

And this is what it looks like when the asphalt is removed.
dsc01743
You can see the connector piece tying the rails together.
dsc01747

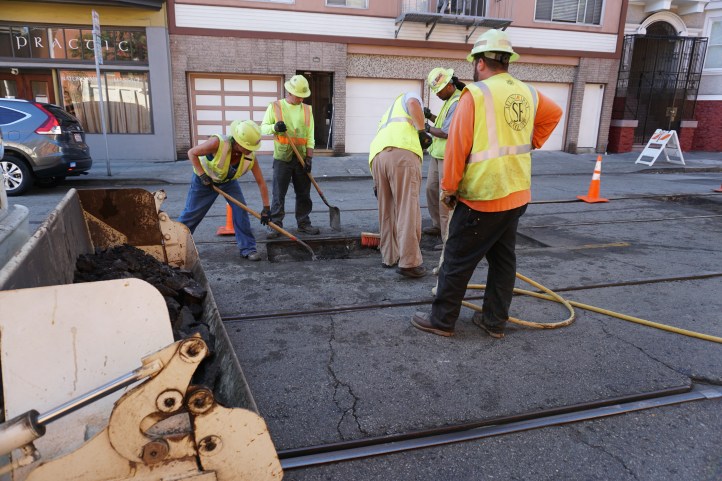

Debris go into the big shovel truck.

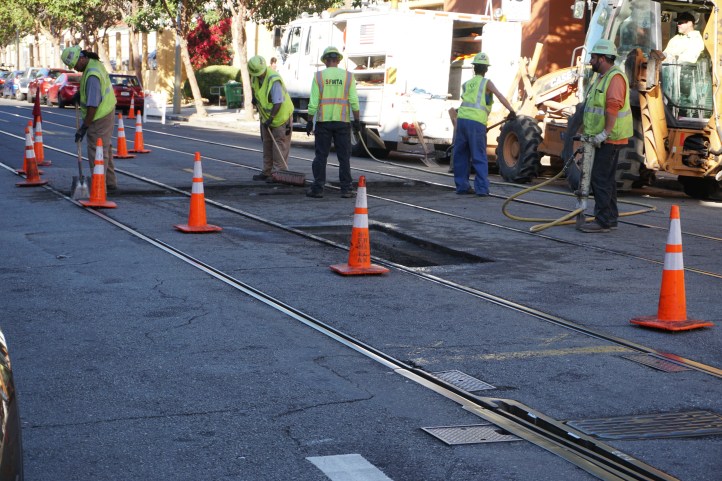

dsc01757

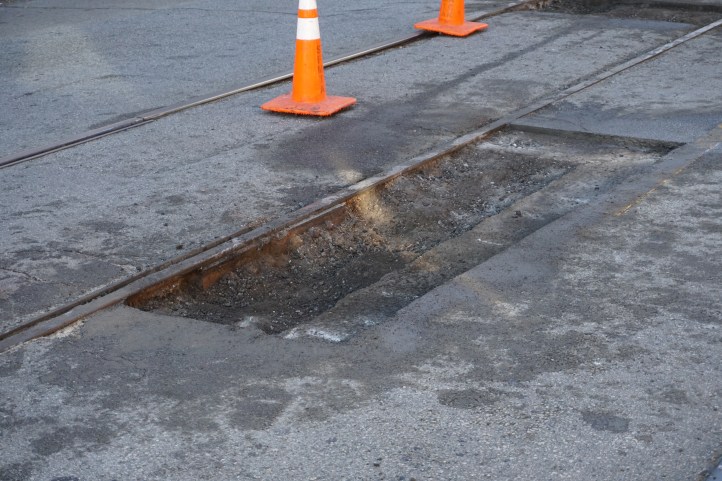

Note the clean well organized work area.
dsc01763

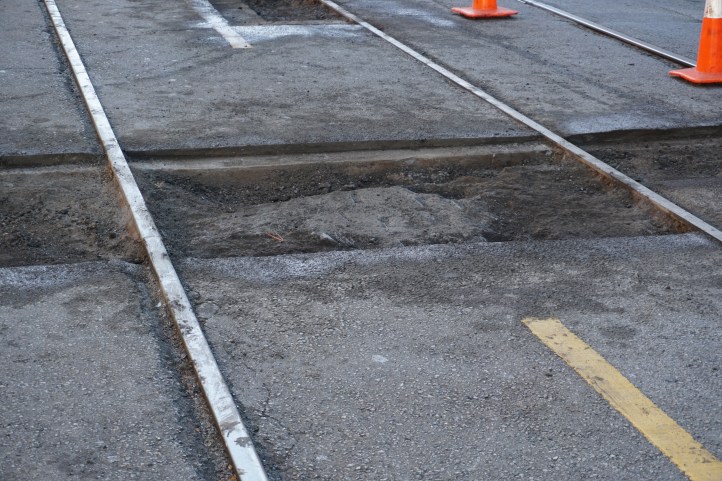

Close up on the rail connector. You don’t want to jack hammer those bolts.

dsc01772

At this point both areas are cut open surgically with no damage to the bolts connecting the rails. The space is clean and ready to fill. Now the set changes a bit. The truck with the loading arm for the old debris dumps its load in the back and takes off. Our team takes a well deserved but wary break while waiting for the 350 degree asphalt to arrive. Then they show us a whole new set of skills.

dsc01787

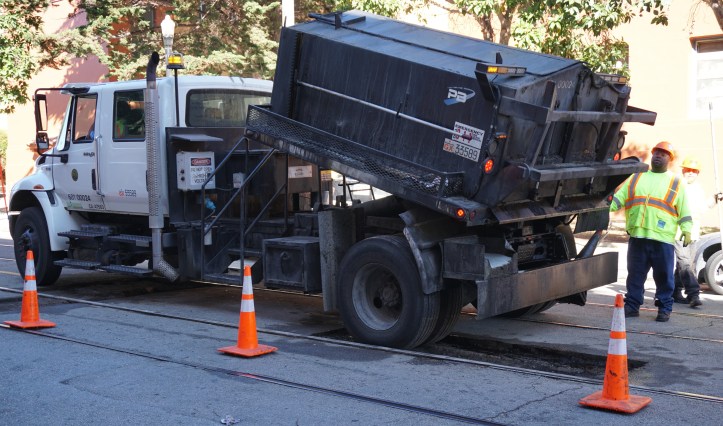

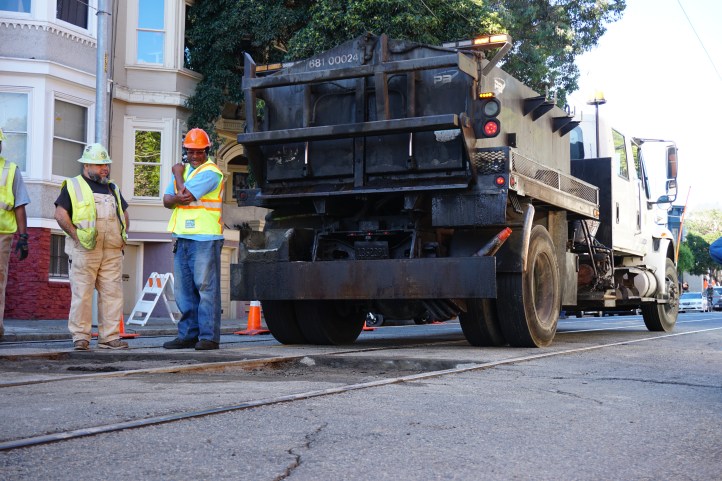

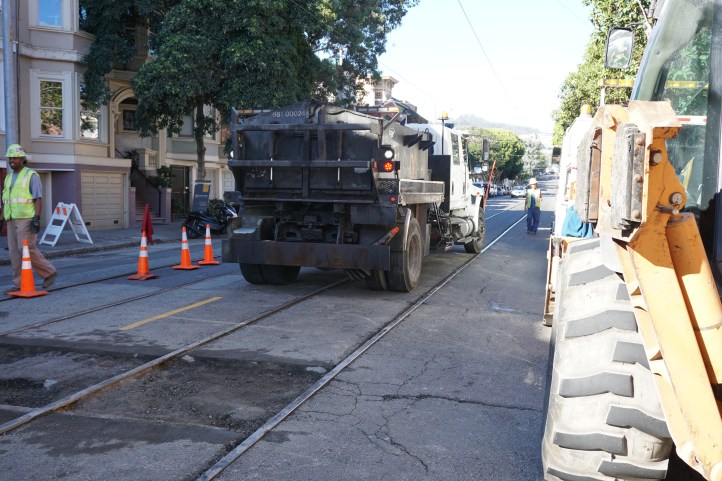

350 degree asphalt arriving.
dsc01793
Dennis Callahan from MUNI welcoming the gentleman from DPW to the site.
dsc01794
This truck is amazing.

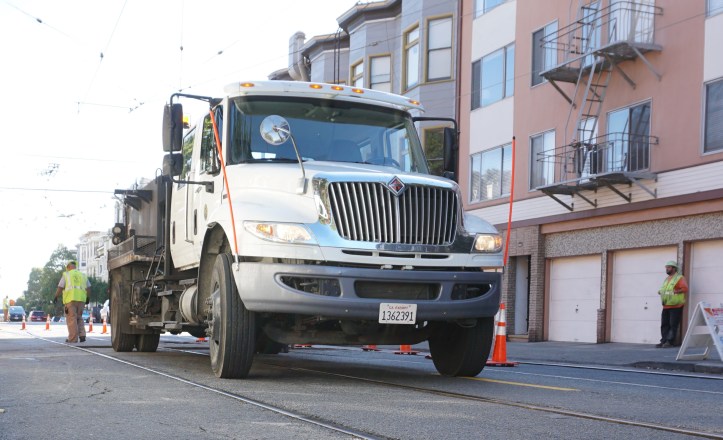

dsc01797

dsc01799
Everything you need to install asphalt on one big factory truck.

dsc01800

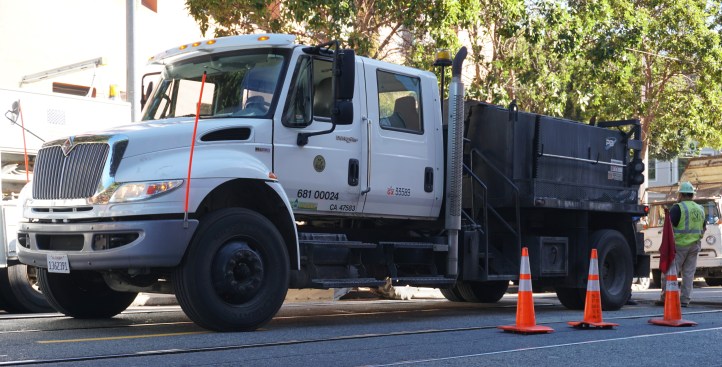

dsc01812
That little staircase is intriguing.
dsc01821

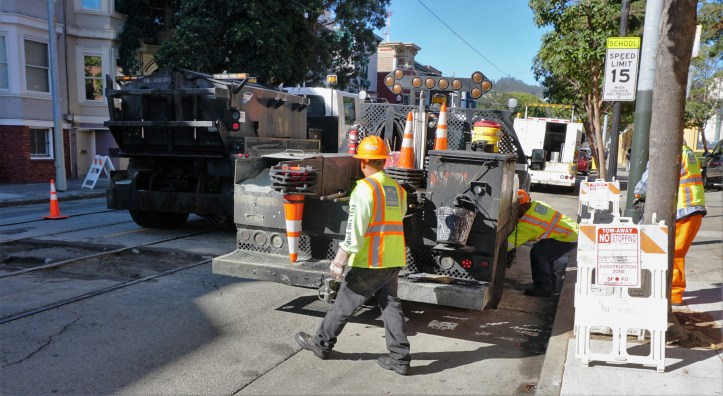

Note the snazzy DPW street safety gear.

dsc01822

dsc01824
Say hello to my little friend…
dsc01831
That is a heated compartment on a lift.

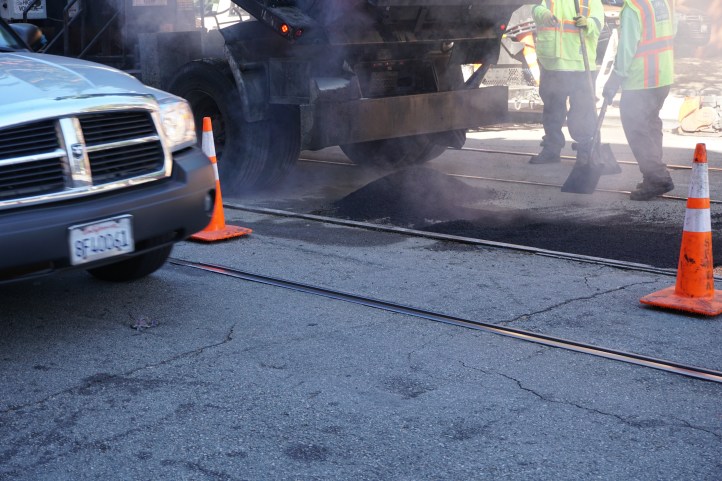

dsc01834dsc01843

dsc01846

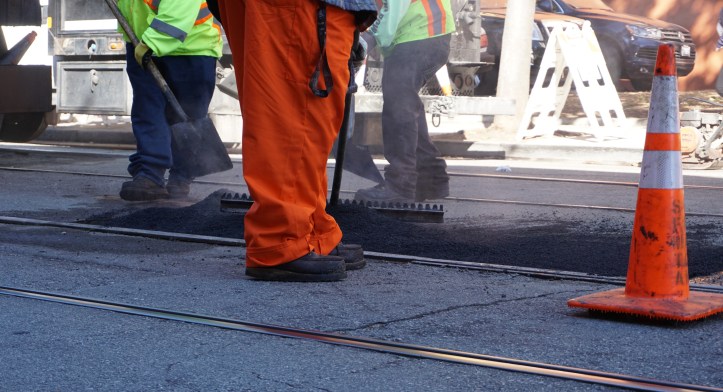

Timing is everything with asphalt.

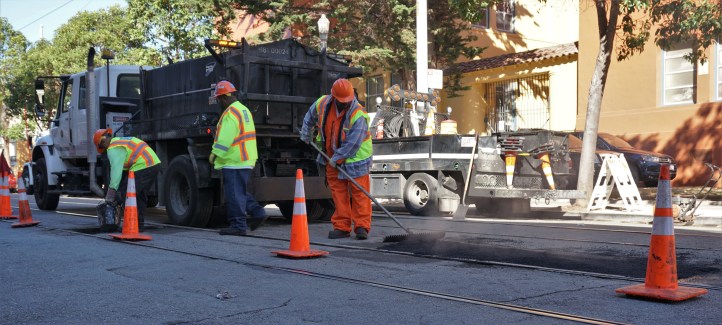

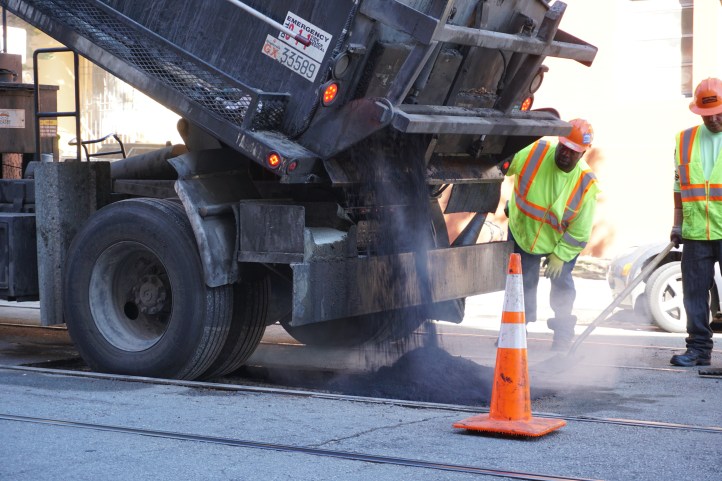

dsc01848dsc01849

dsc01850

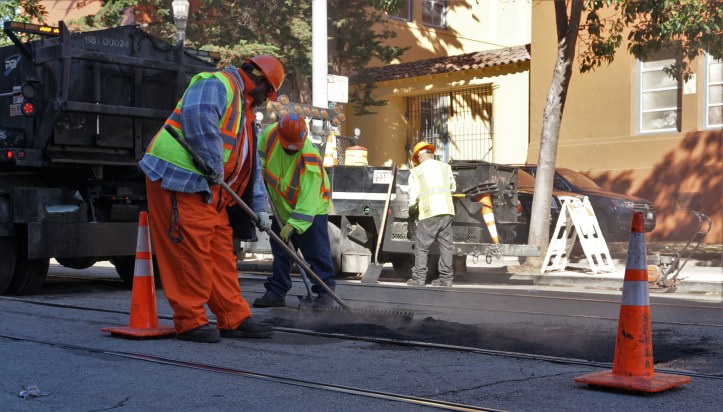

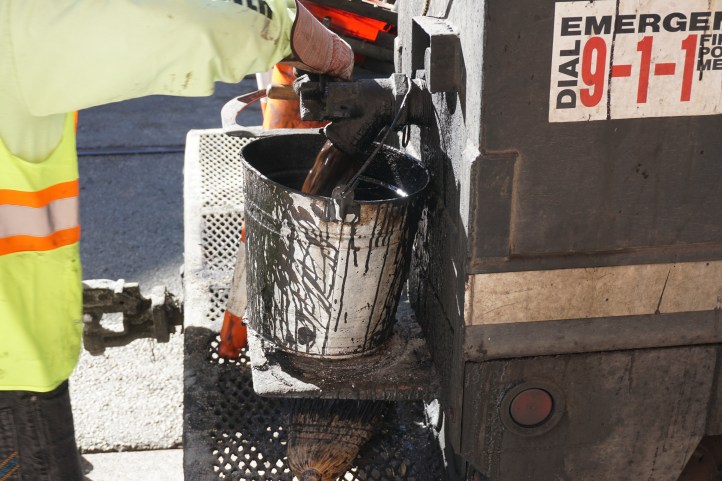

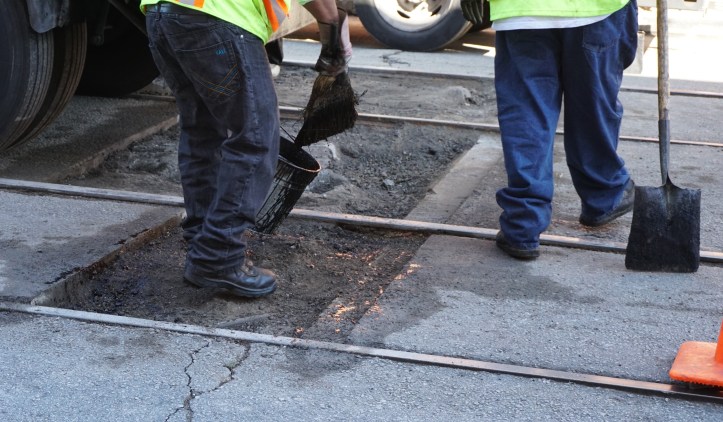

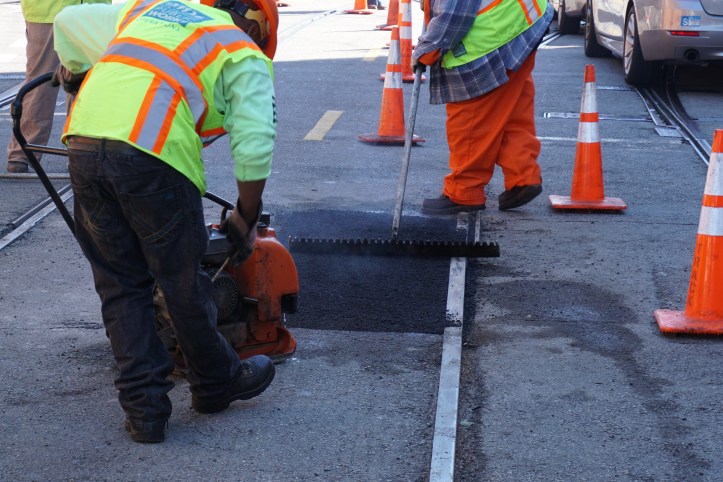

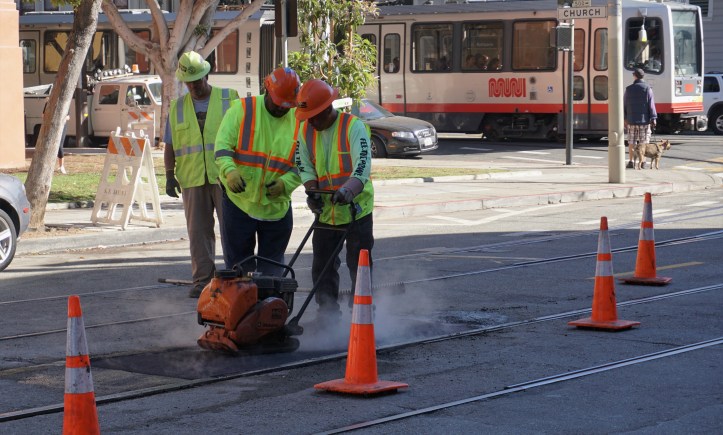

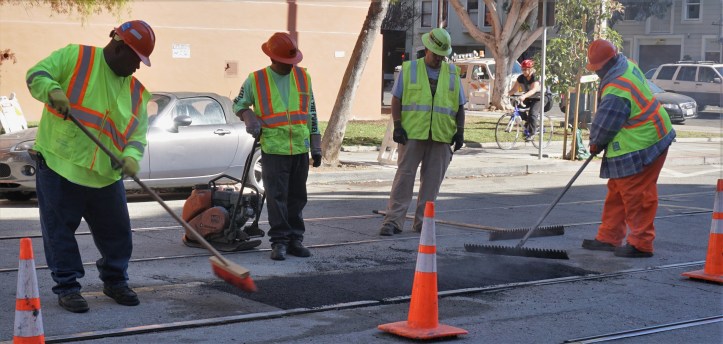

Some kind of oily slurry gets spread on the surface prior to dumping the asphalt.

dsc01856dsc01857

dsc01861

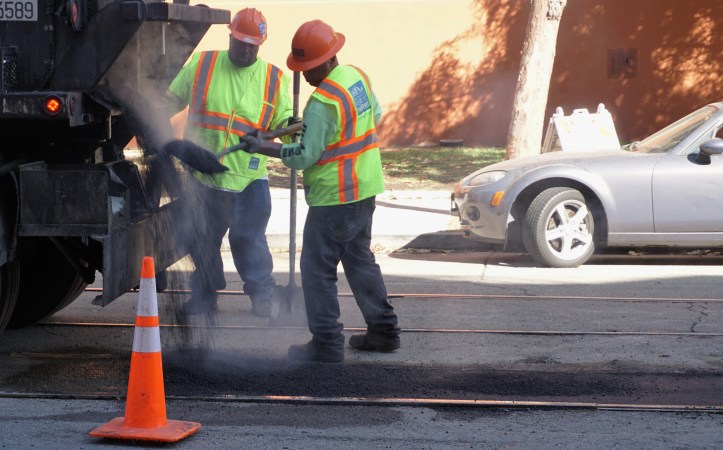

Tamping down the first load
dsc01867
Next comes the second load on top of the compressed first load.
dsc01874

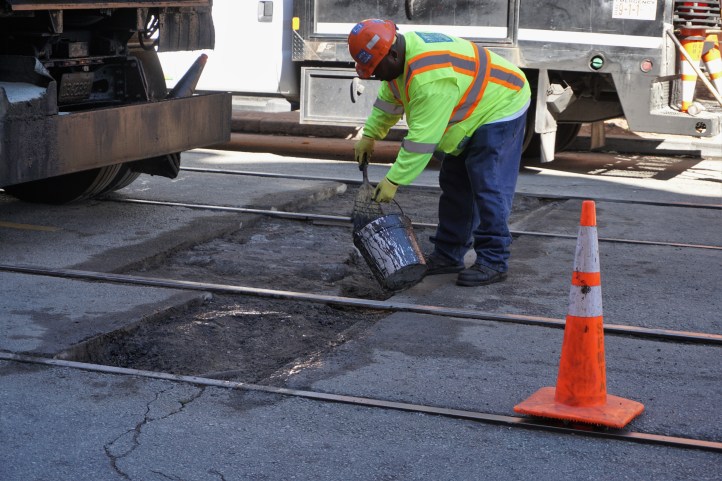

That’s the finish layer.

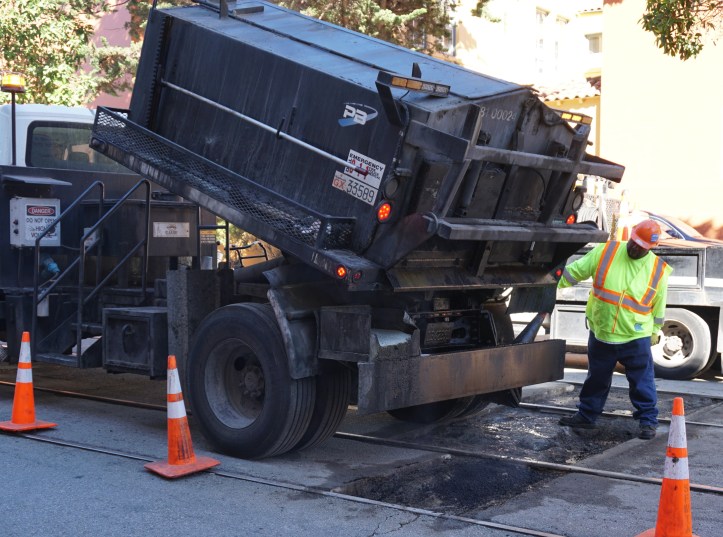

dsc01877dsc01882dsc01895

dsc01919

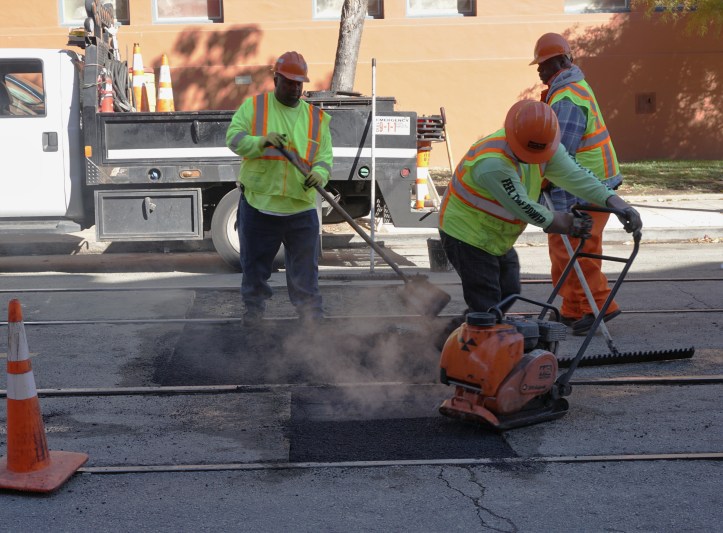

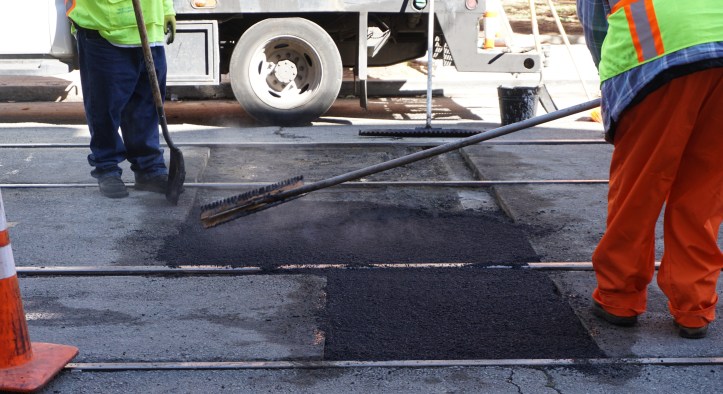

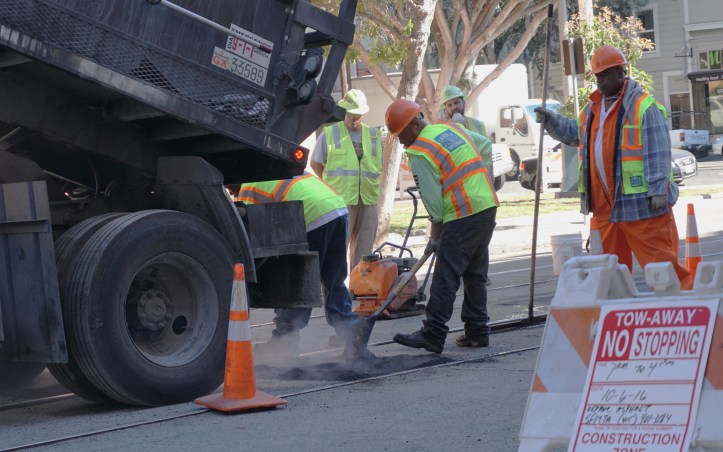

They start with the first two bays.

dsc01923dsc01943

dsc01951
Still leaving the last bay for last.
dsc01952
Complete!!
dsc01954

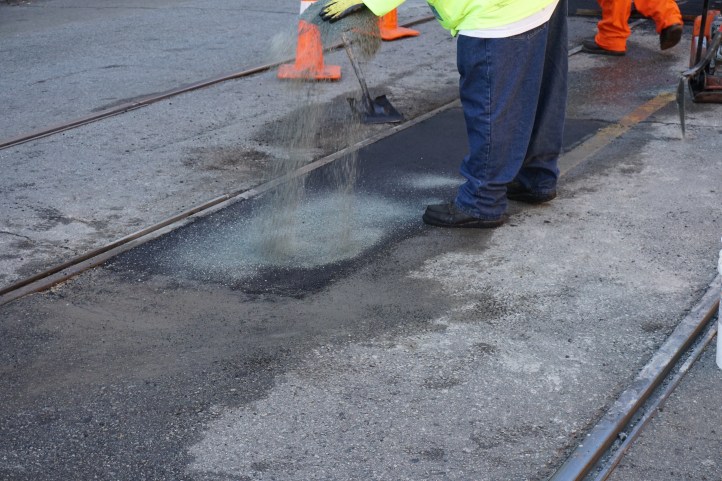

The sand is the very last step. That material is still very hot.

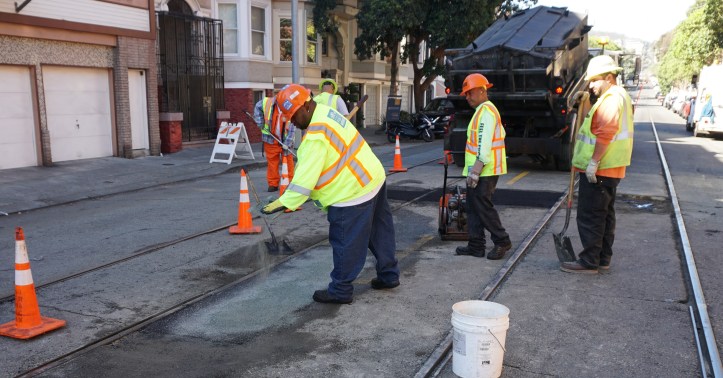

dsc01957

dsc01962
Note how he walks on the rail while pounding the asphalt tight.
dsc01966
Lining up for the final dump.

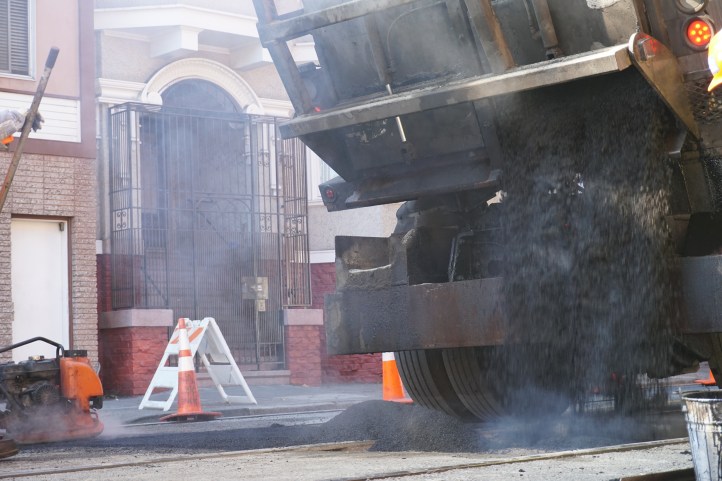

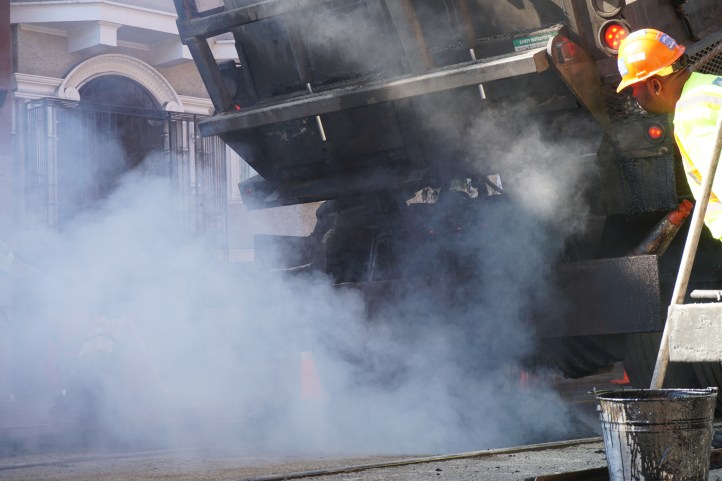

dsc01970dsc01972dsc01979dsc01990

dsc01994

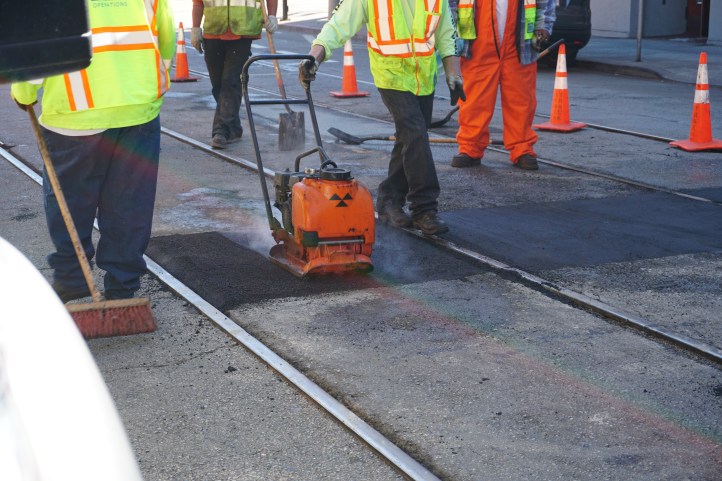

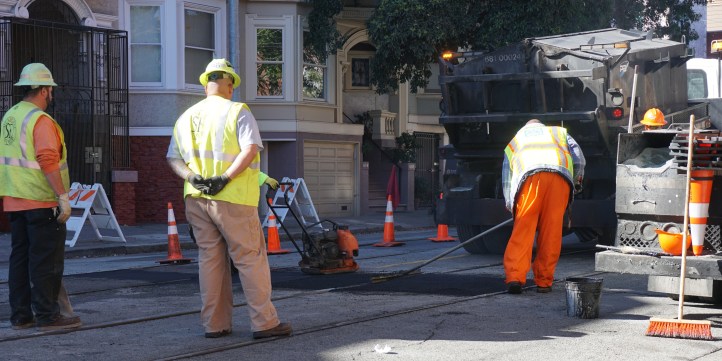

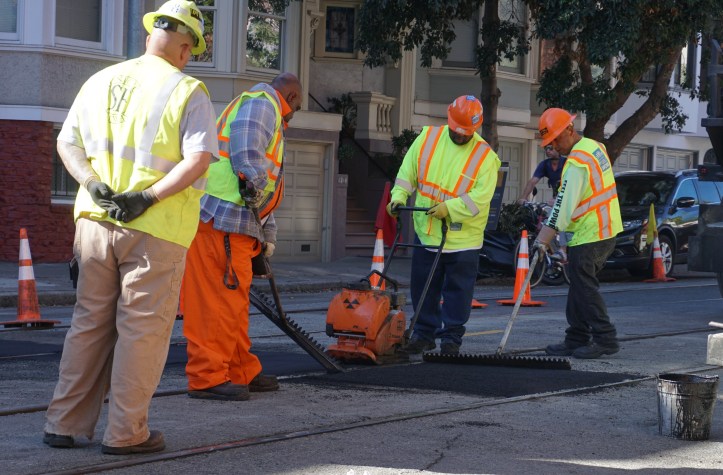

Artists at work.
dsc01999
More rail walking to protect the new surfaces.
dsc02005

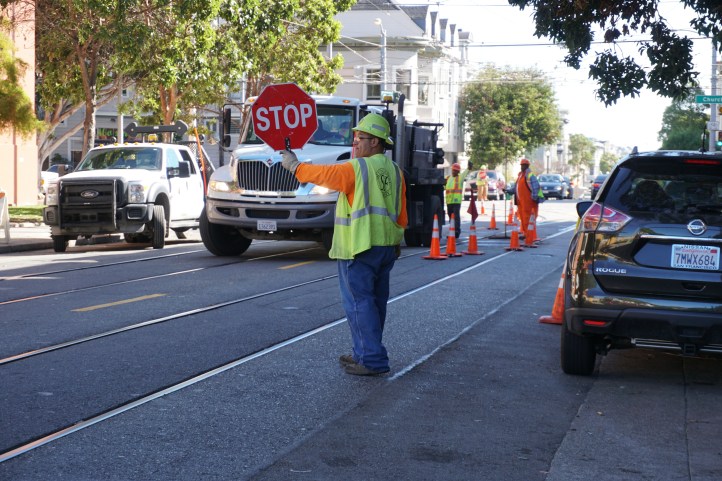

All of this happens in moving traffic under the watchful eyes of these guys.

dsc02013

dsc02017

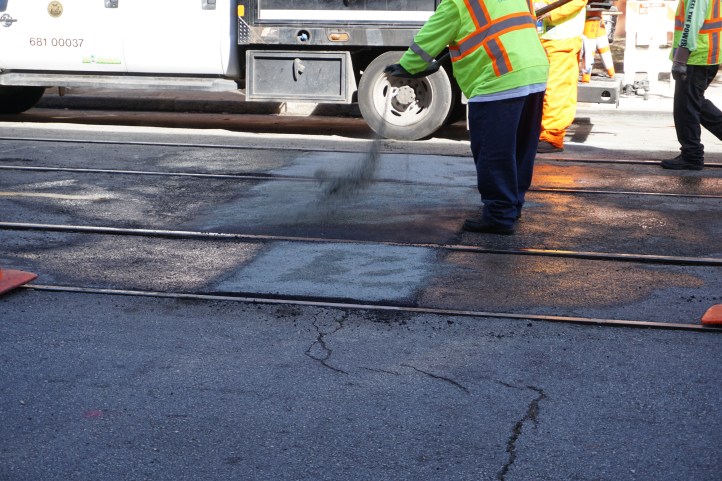

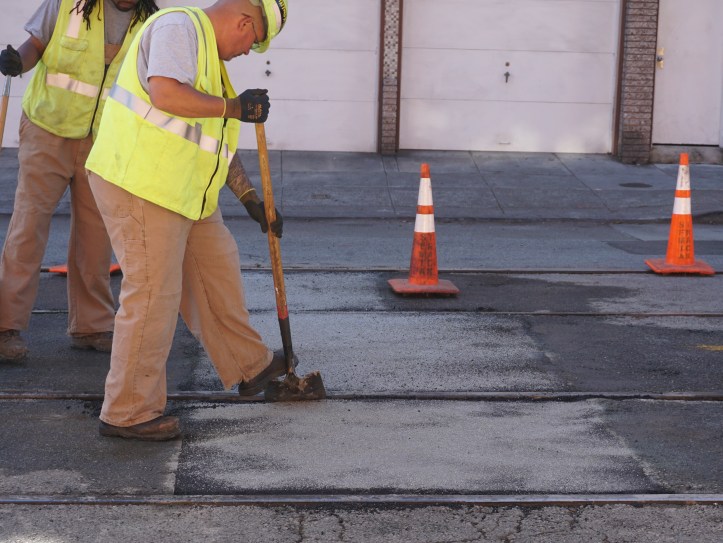

Down goes the sand.
dsc02032
This is how the flange way is created.

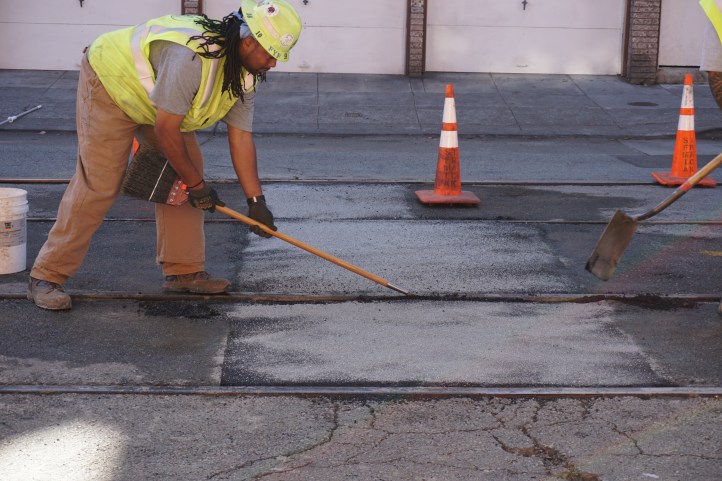

dsc02036
This is high tech stuff.
dsc02046

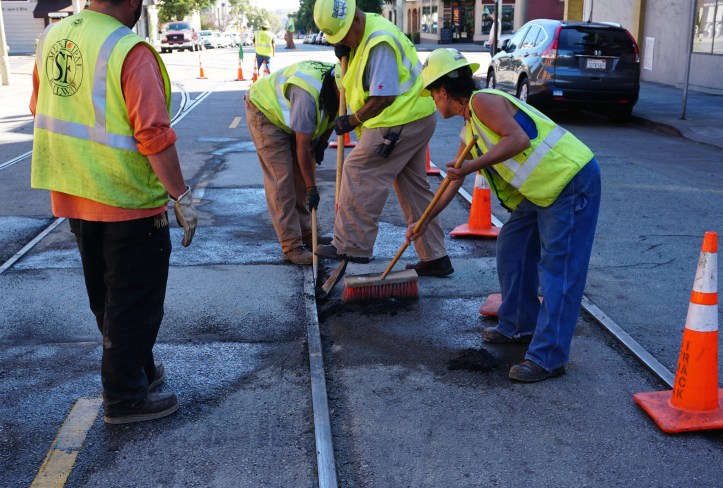

One flange way ready for service.
dsc02056
More flange way formation.

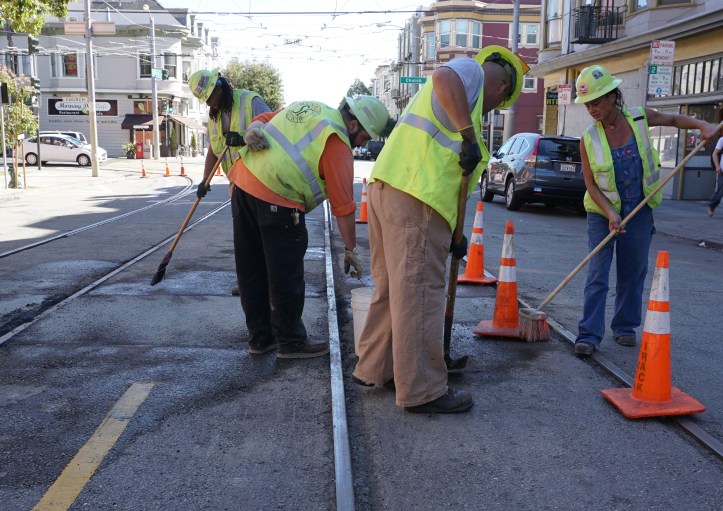

dsc02065
You can feel the end of job energy.
dsc02070
Those last glances look for any missed detail as the crew pulls out.
dsc02075
This tight formation of cones is to let the asphalt cool for an hour or two. The crew sits down for the first time since they started working.

Now we just wait a couple of hours while the asphalt cools and the job is done. Two major pavement irregularities fixed at the cost of several thousand dollars in labor and a major allocation of both skilled labor and resources for an entire day. That’s the cost of maintaining a mixed use roadway with streetcar tracks and automobile and bike traffic.

And, as we mentioned way above, this was only two (2) out of seven (7) areas marked for this treatment on 17th Street. Five more areas are marked and ready for this same treatment at some point yet to come.

According to this study San Francisco is far behind the rest of the country in terms of maintaining quality roads. “Nearly one-third of the nation’s major urban roads are rated in substandard or poor condition, providing motorists and truckers with a rough ride and increasing the cost of operating a vehicle.” (November, 2016 TRIP Report)

If you want to learn more about potholes check out this Tech Brief from the U.S. Department of Transportation Federal Highway Administration.

Having railroad tracks comes with a price tag. They are not free. If MUNI really needs those tracks then MUNI has to be willing to spend the money necessary to maintain them. It seems to us that if indeed the tracks are necessary to the operations of the railroad then the Maintenance of Way should be taken seriously and done right. This day was a good start.

‘Nuff said.
